Comprehensive Guide to Risk Management in Microbiology Labs

Risk management is a structured process that involves identifying risks, assessing their impact, developing strategies to manage them, and implementing mitigation plans using managerial resources. Traditionally, risk management has focused on physical and legal threats such as natural disasters, fires, and accidents. However, modern risk management extends to a wide range of potential threats, including those arising from environmental, technological, human, organizational, and political factors.

Regardless of size, all projects require some form of risk management. Each organization handles and communicates risk differently, influenced by its internal culture and management practices. Effective risk management must consider both internal and external contexts when planning for potential threats—it’s not enough to simply respond to risks after they occur.

A core responsibility of the project manager is to proactively develop and implement strategies that prevent, manage, or recover from risks. These strategies should align with the organization’s key business objectives and be integrated into its overall project management philosophy.

Risk evaluation should go beyond just the schedule and cost. It must also support the long-term development and operation of the business, helping to achieve stakeholder goals without compromising community expectations. This approach may also require stronger knowledge management systems.

This paper explores the comprehensive process of risk management within organizations.

Introduction to Risk Management

Risk is something we all deal with every day—it’s part of life, work, and every decision we make. It exists everywhere: in public and private organizations, in projects, and even in our personal choices. The idea of understanding and preparing for risk has been around for thousands of years. Even the ancient Athenians used risk thinking to guide decisions. However, studying risk as a science is relatively new, only around 30 to 40 years old.

Every organization faces unexpected events. These events can have different causes and effects, and when they lead to negative outcomes, we call them risks. For example, during the COVID-19 pandemic, the global economy was severely impacted. Other examples include:

  • Ericsson lost €400 million after a supplier’s factory caught fire.
  • Apple faced major losses when an earthquake disrupted a memory chip order.
  • British Petroleum (BP) lost over $1.5 billion after a refinery explosion.

So, what exactly is risk? It’s the chance that something bad might happen. The more uncertain a situation is, the more risk it carries. Interestingly, risk also brings opportunity—without risk, there’s often no chance for reward.

Risk management is the process of identifying, analyzing, and responding to these risks. The goal is to reduce the chances of bad things happening and, if they do happen, to lessen their impact. Instead of waiting for problems, risk management encourages planning ahead and acting early.

The ISO 31000 standard defines risk as the “effect of uncertainty on objectives.” That means risk can either be a threat or an opportunity. Risk management involves using tools and resources wisely to control or reduce potential dangers and make the most of positive chances.

We also need to understand hazards—these are things that could cause harm. Once we identify possible hazards, we assess how likely they are to happen and how bad the effects would be. This is called risk assessment. It helps us decide what actions to take and which risks need the most attention.

Roles: Risk Manager vs Analyst

In many organizations, some people specialize in this:

  • A Risk Manager leads the process, looking at all possible risks that could affect safety, finances, or reputation and making plans to handle them.
  • A Risk Analyst gathers and analyzes risk data, then advises the manager on the best decisions.

Experts like Cagliano et al. (2015) have even created frameworks to help organizations choose the right risk management techniques depending on their experience and project type. Tools like FMEA (Failure Mode and Effects Analysis) and FMECA (Failure Mode and Effects Criticality Analysis) are used to predict and prevent failures.

Risks are often grouped into categories such as:

  • Corporate and Academic Governance.
  • Academic Quality.
  • Student Satisfaction
  • Operational.
  • Health and Safety.
  • Regulatory Compliance.

Methods & Tools

In addition, there are many formal tools available: ‘ Fault Tree Analysis ‘ (FTA), ‘Hazard Analysis and Critical Control Points ‘ (HACCP), ‘ Hazard Operability Analysis ‘ (HAZOP), and ‘ Preliminary Hazard Analysis ‘ (PHA) [9]. Finally, at the end of the path, we could consider that “all management is risk management”.

Key Definitions and Terminology

The basic methods for risk management—avoidance, retention, sharing, transferring, and loss prevention and reduction—can apply to all facets of an individual’s life and can pay off in the long run [10]. For further knowledge about risk management, there are some important definitions:

Quality Risk Management (QRM):

A systematic process for the risk assessment, control, communication, and review of risks to the quality of the pharmaceutical product across the product life cycle.

Risk Assessment:

A systematic process of organizing information to support a risk decision to be made within a risk management process. It consists of the identification of hazards and the evaluation of the risk associated with exposure to those hazards.

Harm:

Damage to health, including damage occurring from loss of product quality or availability.

Hazard:

The potential source of harm.

Risk:

the combination of the probability of occurrence of harm and the severity of that harm, and the detectability of that harm.

Failure:

The condition or fact of not achieving expected results, a cessation of proper functioning or performance.

Risk Identification:

The systematic use of information to identify potential sources of harm (hazards), referring to the risk question or problem description.

Risk Analysis:

The estimation of the risk associated with the identified hazards.

Risk Evaluation:

The comparison of the estimated risk to given risk criteria using quantitative or qualitative scale to determine the significance of the risk.

Risk Control:

Items in place and/or actions to implement the risk management decision.

Risk reduction:

The process of decreasing the level of risk.

Mitigation Plan:

a plan to minimize the likelihood of risk or increase the detectability of the risk to increase patient safety to an acceptable level of assurance.

Severity:

a measure of the possible consequences of a hazard.

Detection:

The ability to discover or identify a risk or failure.

Occurrence/probability:

The likelihood that the cause of the failure will occur, resulting in harm to the patient.

Risk prioritization number (RPN):

a quantitative method of determining the level of risk by multiplying the severity, occurrence, and detectability ranking of the failure or event.

FMEA:

Failure Mode Effects Analysis is a tool for systematically reviewing the causes, effects, and risks of systems or process failures.

Formation of QRM team:

QRM team is a cross-functional team (team members are from different technical departments) and the members shall have specific knowledge and experience regarding the products and processes scope of the risk.

FLOW CHART FOR RISK MANAGEMENT PROCEDURE

FLOW CHART FOR RISK MANAGEMENT PROCEDURE

Sources of initiating risk:

Risk can arise from potential hazards or be triggered by specific events. These triggers and potential causes are commonly grouped as follows:

🔸 Common Risk Triggers (including but not limited to):

  • Change Control Reports
  • Corrective and Preventive Actions (CAPA) related to major or critical deviations
  • Regulatory changes, such as:
    • Upcoming legislation
    • Modifications in existing laws
    • Changes in the pharmacopoeial standard
  • CAPA outcomes from internal or external audits
  • Product reviews, including
    • Poor process capability (e.g., low CPK values)
    • Recommendations of the approved Annual product review

🔸 Potential Risk Causes (including but not limited to):

  • Facility Design and Qualification:
    • Impact of facility, equipment, or system design on product quality
    • Implementation of new technologies
  • Facility Maintenance, Monitoring, and Control:
    • Frequency and quality of scheduled maintenance
    • Calibration schedules and consistency
  • Storage and Transportation Conditions:
    • Inappropriate or unstable environmental/climatic conditions during storage or transit

Risk Assessment Process

Risk Identification – What Might Go Wrong?

The risk owner is responsible for initiating risk assessment activities. This begins by applying Failure Mode and Effects Analysis (FMEA) to identify and describe the risk.

How to Write a Risk Title:

Use structured formats for clarity and consistency. Examples:

  • Format 1:
    “There is a risk that/of [specific risk] because of [cause], resulting in [impact].”
  • Format 2:
    “There is a risk that [what is at risk] will not [be achieved/be successful] due to [issues or threats]. This will result in [consequences if not addressed].”

Risk Analysis Steps

The QRM team is responsible for performing the following tasks:

  • Quantitatively assess risk by linking:
    • Severity
    • Detection
    • Probability
  • Identify and document the possible failure modes.
  • Assign a severity value by evaluating the impact of the failure or unwanted event according to the table below:.
This means RankingSeverity
Impact is not related to a system CA, CQA or CPP. No impact to compliance status.2-4Low
Definitive impact on a system CA, CQA, or CPP. High impact on compliance status.5-7Medium
Definitive impact on a system CA, CQA, or CPP. High impact on compliance status.8-10High
  • Determine Cause of Failure
    • List all potential causes of failure.
    • If multiple causes exist, list them individually for separate evaluation.
    • Identify the existing procedural or design controls that help detect each failure.
    • Assign a detectability value based on how effectively these controls can identify the issue.

Assign detectability value i.e. to what extent the in-place control measure will detect the cause or the failure, according to the table below:

This meansRankingDetection risk
The detection mechanism is located within the process step however, it may be moderately delayed.2 – 4Low
The detection mechanism is located multiple process steps downstream and may be significantly delayed..5 – 7Medium
A detection mechanism is in place that will consistently detect the event it may be real real-time alert.8 – 10A detection mechanism is in place that will consistently detect the event, it may be real real-time alert.

Assign a probability value by determining to what extent the in-place control measure will prevent the cause of the failure occurrence, according to the table below:

This meansRankingProbability
The event has occurred more than one time and has a possibility of occurring again.2 – 4Low
The event has occurred multiple times and continues to occur.  5 – 7Medium
Event has occurred multiple times and continues to occur.  8 – 10High

Risk Evaluation

Once risk analysis is complete, the QRM team proceeds with risk evaluation by:

  • Calculating the Risk Prioritization Number (RPN)
    (RPN = Severity × Detectability × Probability)
  • Comparing results against risk acceptance criteria.
  • Classifying each risk as:
    • Minor
    • Major
    • Critical

Risk Acceptance Criteria

  • Minor Risk:
    • Acceptable; no additional action needed.
    • Ensure control measures are already in place.
  • Major or Critical Risk:
    • Requires additional control or mitigation measures.
PRNRisk factorAction taken
8 – 64MinorThe risk associated is low. No additional controls are needed. Document rationale for acceptance.
125 – 343MajorThe risk associated may be acceptable but additional controls may need to be taken to mitigate the risk. These actions should be targeted at bringing the risk into acceptable level. Document acceptance rationale and/or additional controls.
512 – 1000CriticalThe risk associated is high and additional controls are required to mitigate the risk. If it is determined that additional controls are not feasible/possible, a formal risk acceptance rationale must be documented. Ensure additional controls, if identified, are documented.

Risk Control and Reduction

Risk reduction involves actions aimed at decreasing the probability or increasing the detectability of the identified risks.

If the risk is classified as major or critical, the risk owner must:

  • Define a mitigation plan to lower the risk to an acceptable level.
  • Collaborate with the QRM team to finalize the plan.
  • The QRM coordinator submits the approved risk assessment report and mitigation plan to the relevant departments for implementation.

Risk Follow-Up and Reassessment

After implementing mitigation:

  • The QRM coordinator follows up on the execution of the mitigation actions.
  • The risk owner must:
    • Record proposed and actual closure dates.
    • Justify if the timeline is exceeded.
    • Reassess severity, probability, detectability, and RPN after implementation.
    • Work with the QRM team to determine if further actions are required.

Risk Communication

Effective communication is essential to ensure alignment across departments.

  • Share mitigation measures and risk outcomes clearly and promptly.
  • Distribute approved risk assessment reports to all involved teams.
  • Hold risk board meetings to communicate between departments, contractors, and health authorities (e.g., MOH).

Documentation and Archiving

All steps in the QRM process must be properly recorded:

  • Risks are logged using a specific attachment template.
  • The output and results are:
    • Documented
    • Reviewed
    • Approved
    • Archived by the QRM coordinator in QA or designated departments.

Risk Coding System in Pharmaceutical QRM

To ensure consistency and traceability in Quality Risk Management (QRM) documentation, each risk is assigned a unique code using the following format:

  • Code Format: Serial Number / Year (e.g., 001/2022)

Yearly Risk Log Should Include📋

FieldDescription
YearThe calendar year when the risk was assessed
Risk Serial NumberUnique number assigned to each risk
Date of the RiskThe date the risk was officially recorded
Risk TitleA brief, descriptive name of the risk
Risk Coordinator SignatureSignature of the person responsible for the assessment
QA Manager SignatureConfirmation by the QA Manager from the concerned department

Important QRM Abbreviations

For clarity across cross-functional teams, here are the key abbreviations used in pharmaceutical risk management:

CQA – Critical Quality Attribute QRM – Quality Risk Management CA – Critical Attributes CPP – Critical Process Parameters

Risk Management Example in Microbiology Laboratories

The following example illustrates how risk management is applied in a microbiology lab, particularly in micro-analysis processes within the pharmaceutical industry:

Scope: This risk assessment addresses the microbiological testing process and identifies failure points that could impact product safety and quality.

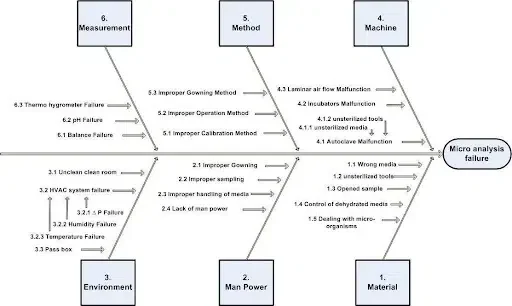

fishbone

Example Failure Mode:

ItemPotential Failure ModeEffectsCurrent ControlsRisk Rating
(S-O-D-RPN)
Status
1.1Balance FailureIncorrect weight affects sample qualityDaily balance verification and annual calibrationS: 10
O: 1
D: 1
RPN: 10
Accepted

Process Opportunities in Quality Risk Management

Implementing Quality Risk Management (QRM) in pharmaceutical settings not only mitigates threats but also opens up numerous opportunities for process improvement:

Key Process Opportunities:

  • Improved Work Environment – Safer and more structured practices for employees
  • Enhanced Productivity – Streamlined processes and fewer disruptions
  • Operational Efficiency – Better resource management, reduced waste, and cost savings

Expanding QRM Across Pharmaceutical Systems

The principles and tools of QRM are now being applied widely across the pharmaceutical quality system, including:

  • Drug development
  • Manufacturing
  • Distribution
  • Regulatory inspections
  • Submission and review processes

This also includes risk assessments related to:

  • Microbiological contamination
  • Raw materials
  • Solvents and excipients
  • Packaging and labeling components

Such integration ensures compliance and product integrity throughout the entire product lifecycle.


Results of Risk Management Implementation

Monitoring and Review

The monitoring and review process is essential for maintaining the effectiveness of risk management strategies. It should:

  • Be planned and assigned with clear responsibilities
  • Occur at all stages of the project
  • Include planning, data collection, feedback, and performance evaluation
  • Be part of organizational performance measurement and reporting

Benefits of Risk Management

A well-executed risk management strategy brings tangible benefits:

  • Ensures continuous improvement throughout the project
  • Enhances stakeholder confidence and decision-making
  • Reduces unexpected disruptions and project failures
  • Improves problem-solving and control mechanisms
  • Helps all parties understand and prepare for potential threats

While risk management may add cost, its value outweighs the investment—helping avoid costly mistakes and supporting long-term success.

Risk Culture Approaches:

  • Risk-Neutral Firms: Acknowledge risk but invest minimally
  • Risk-Averse Firms: Avoid risk entirely, limiting innovation
  • Risk-Seeking Firms: Embrace risk and pursue higher rewards (often called “gamblers”)

Ultimately, the chosen risk philosophy directly influences project outcomes.


Conclusions: Embedding Risk Management in Culture

Risk management should become part of the organizational culture, not just a one-time process. This enables:

  • Standardization in project planning and execution
  • Knowledge management and lesson sharing across future projects
  • Proactive thinking, flexible strategies, and smarter decisions
  • Turning risks into opportunities for innovation and profit

Risk is inevitable—but with the right mindset and tools, its impact can be minimized and benefits maximized.

References

  1. Zumbrun, Josh (10 May 2020). “Coronavirus Slump Is Worst Since Great Depression. Will It Be as Painful?” The Wall Street Journal.
  2. Christopher S. Tang., Perspectives in supply chain risk management, International Journal of Production Economics, October 2006.
  3. U.S. Refineries Operable Capacity. Department of Energy, Energy Information Administration. July 2008
  4. Hubbard, Douglas (2009). The Failure of Risk Management: Why it is Broken and How to Fix It. John Wiley & Sons. p. 46
  5. Risk Manager, Society for Human Resource Management.
  6. What Are Risk Analysts & Risk Managers?CFA Institute.
  7. Wilhelm-Martin Bissels, Managing risk and uncertainty in research projects with experiments, September 2018, 5 PUBLICATIONS, P.24.
  8. S P Jain school of Global Management, Risk Management Frame work June 09, 2021, P.4.
  9. ISO 31010:2019 Risk management – Risk assessment techniques.
  10. JEA YU, 5 basic methods for risk management, Investopedia.com, June 28, 2021.

Leave a Comment

Your email address will not be published. Required fields are marked *

Scroll to Top
